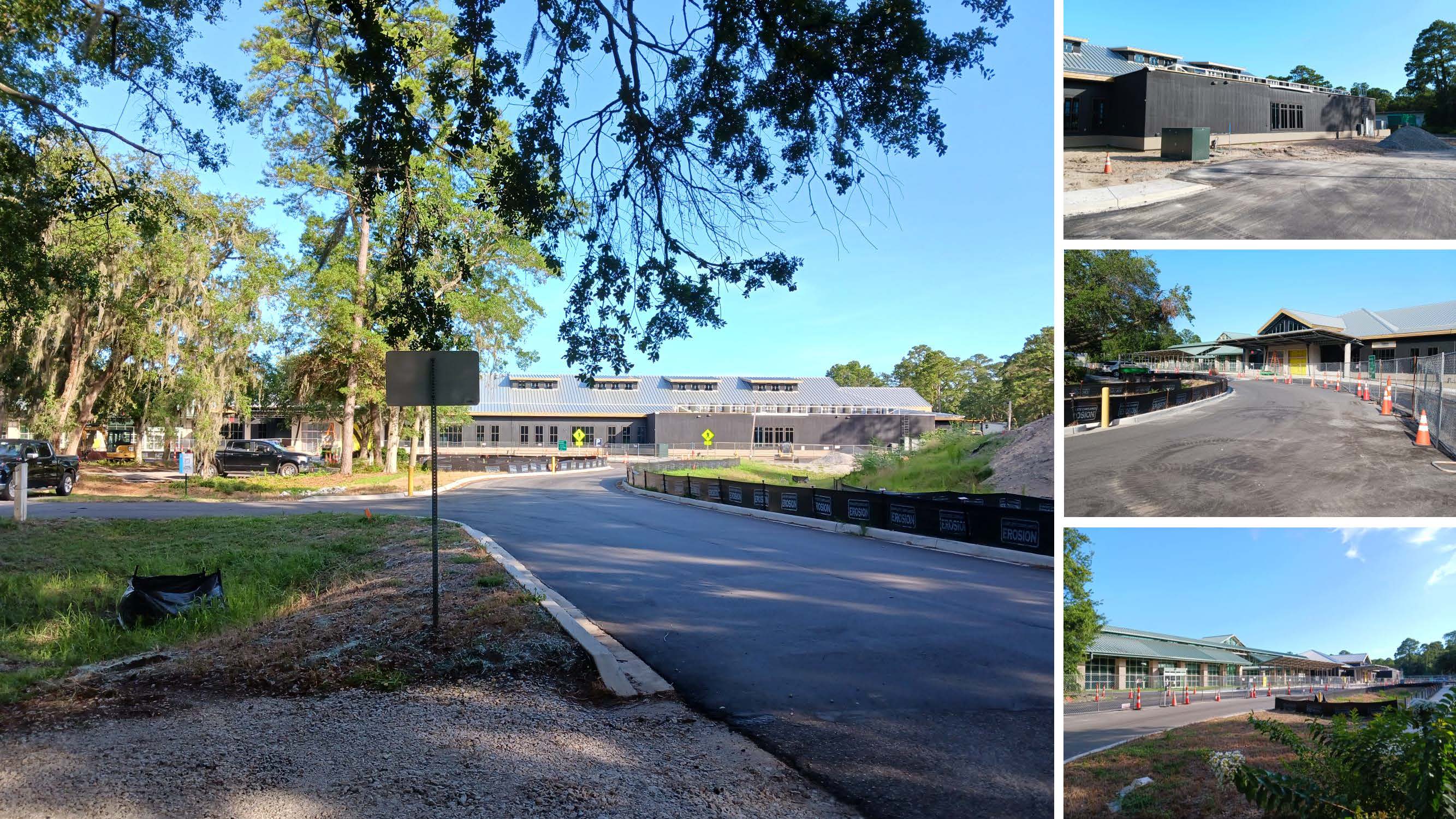

Share Mid-month Photo Highlights - July 15, 2025 on Facebook
Share Mid-month Photo Highlights - July 15, 2025 on Linkedin
Email Mid-month Photo Highlights - July 15, 2025 link

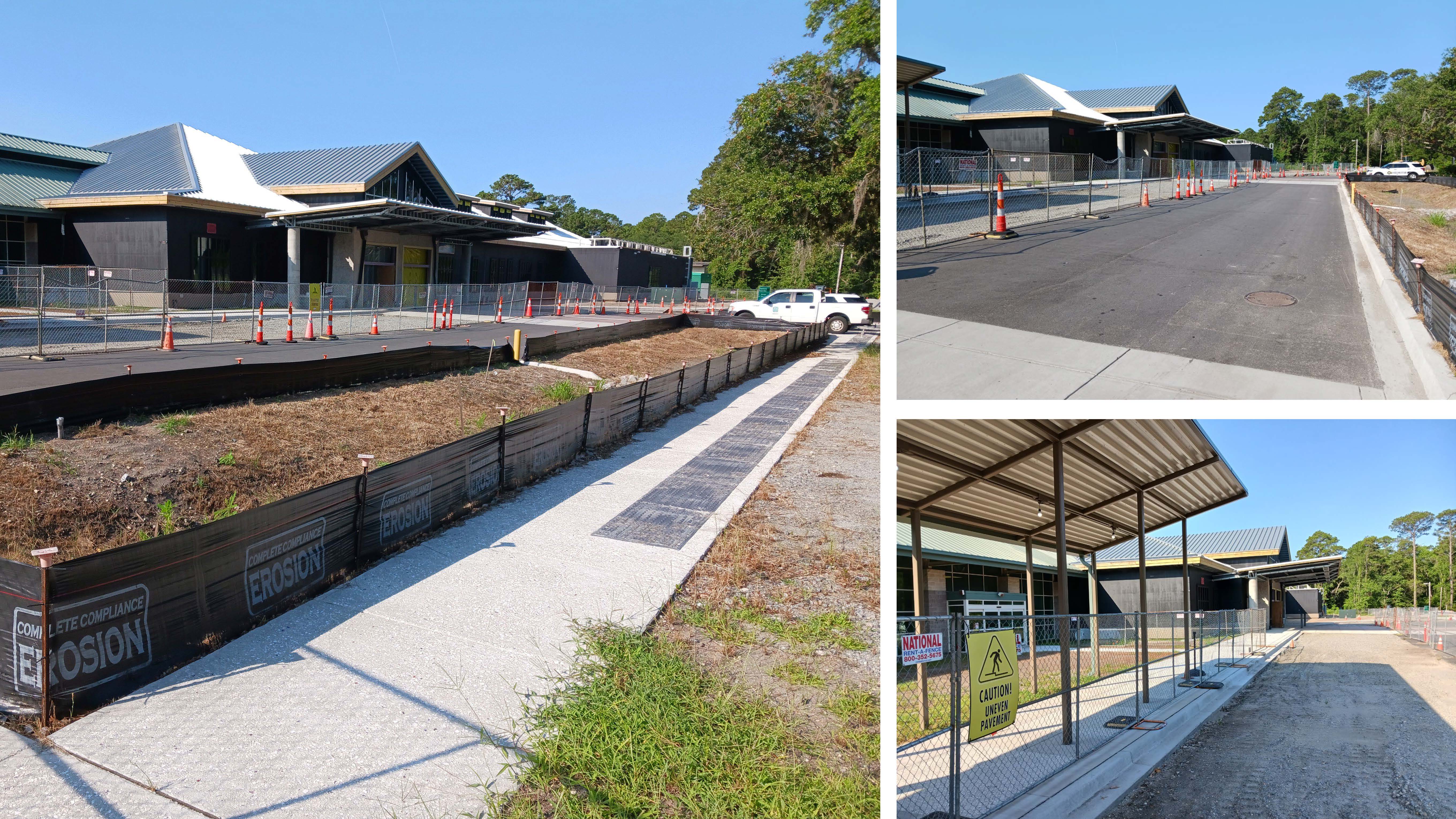

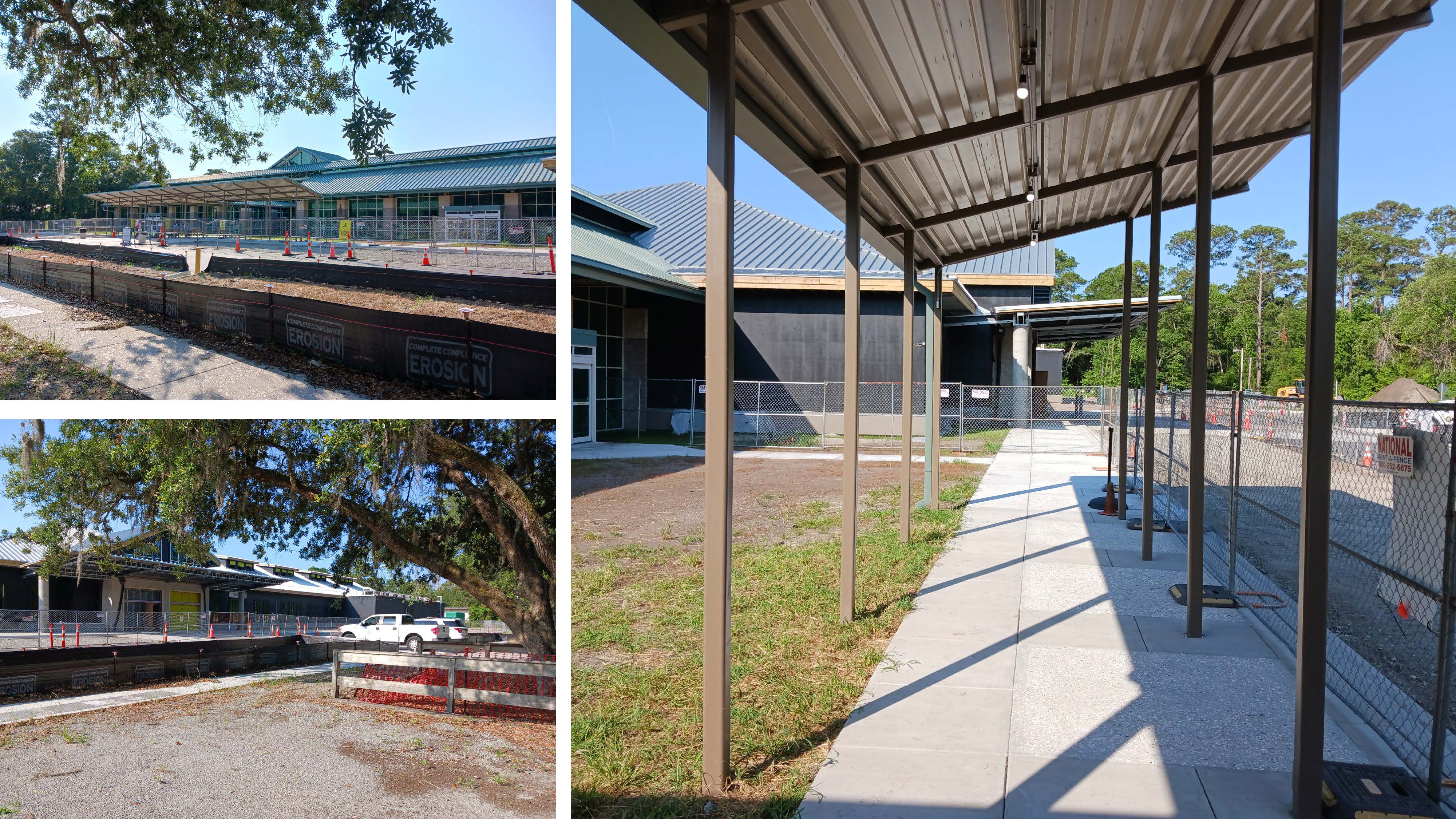

Share End-of-Month Photo Highlights - June 30,205 on Facebook
Share End-of-Month Photo Highlights - June 30,205 on Linkedin
Email End-of-Month Photo Highlights - June 30,205 link
Share End-of-Month Photo Highlights - May 30, 2025 on Facebook
Share End-of-Month Photo Highlights - May 30, 2025 on Linkedin
Email End-of-Month Photo Highlights - May 30, 2025 link
Share Mid-Month Photo Highlights - May 15, 2025 on Facebook
Share Mid-Month Photo Highlights - May 15, 2025 on Linkedin
Email Mid-Month Photo Highlights - May 15, 2025 link
Share End-of-Month Update and Photo Highlights - April 30, 2025 on Facebook
Share End-of-Month Update and Photo Highlights - April 30, 2025 on Linkedin
Email End-of-Month Update and Photo Highlights - April 30, 2025 link
KEY WORK ITEMS ACCOMPLISHED

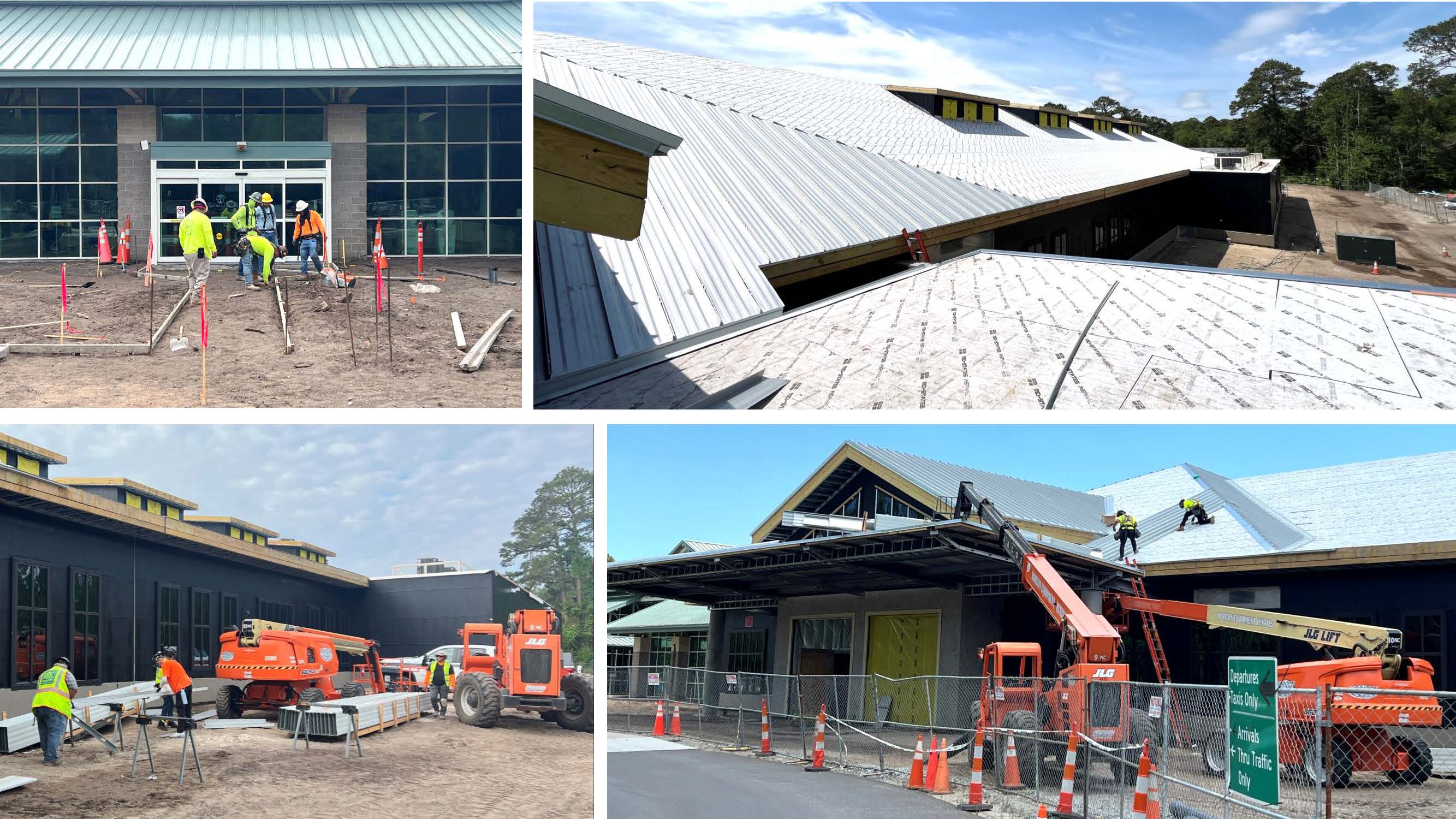

- Roof installation 90% complete

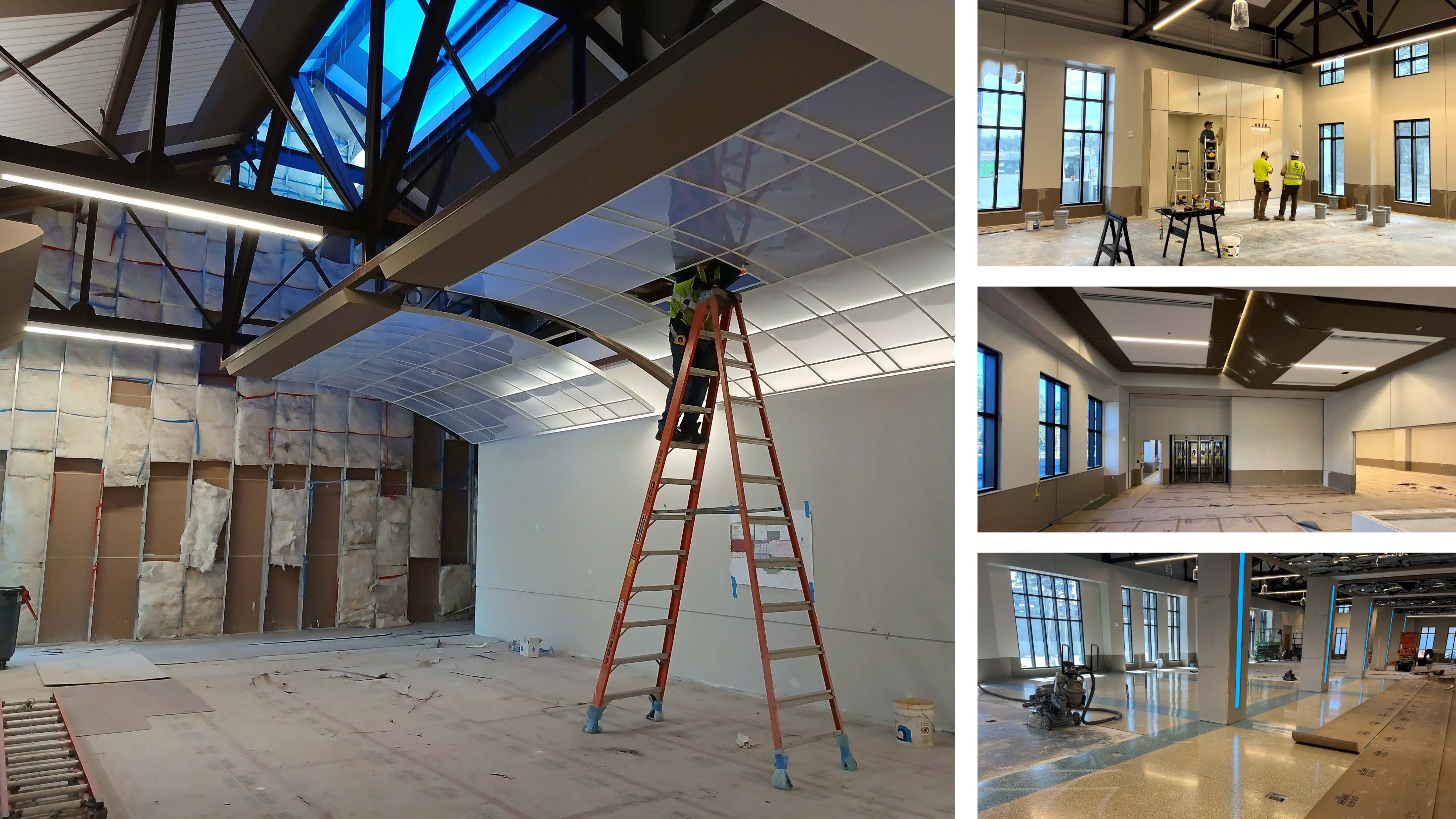

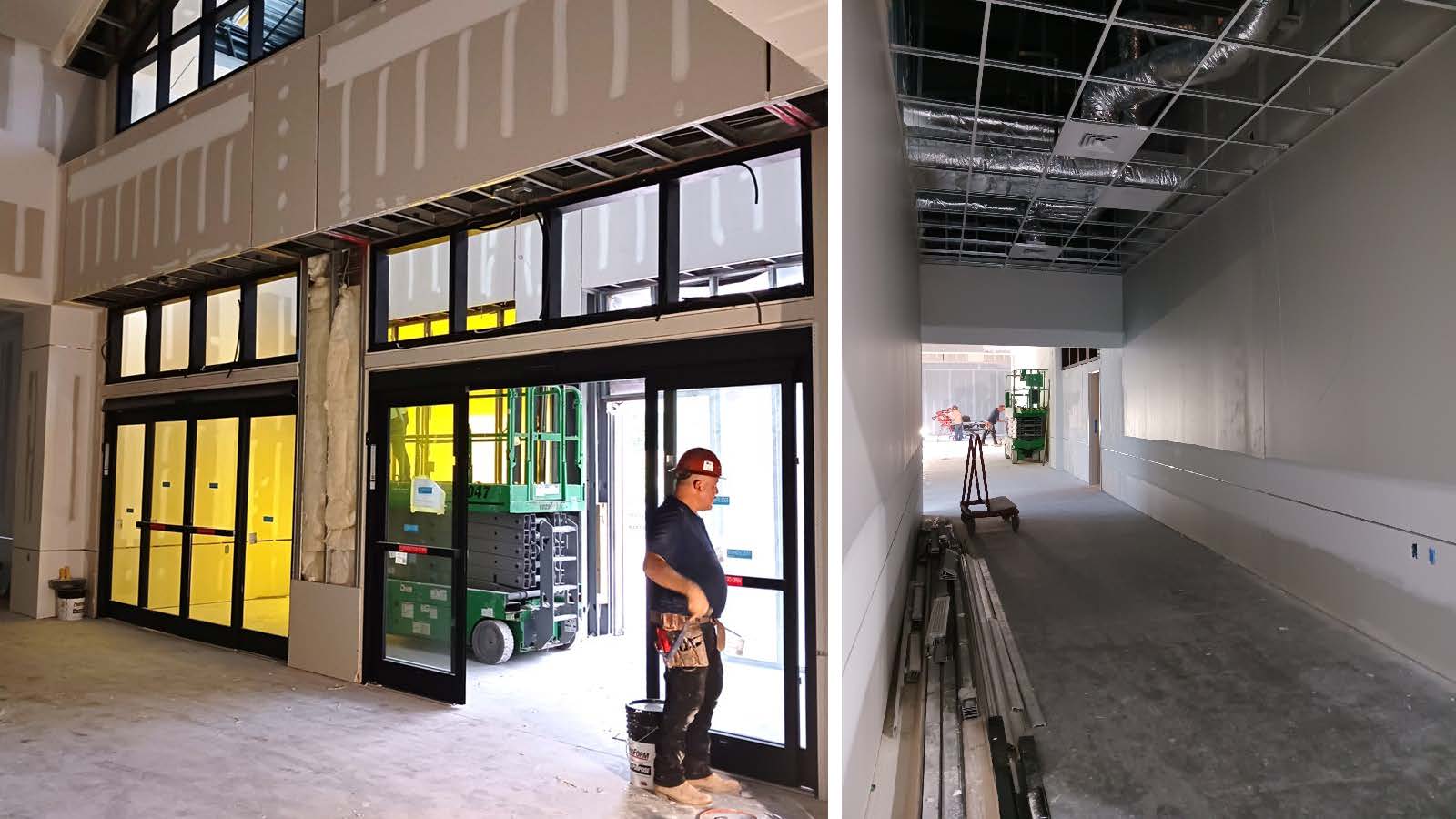

- Sheetrock installation 40% complete
- Exterior doors installed
- Interior water/HVAC/electrical/ Fire suppression 90% complete
- Window frames and glass installed.
- Exterior EFIS is complete
IMPORTANT COORDINATING ITEMS
- Continue safely routing passengers through construction zones
- Approve interior graphics, light fixtures and accessories
- Next big step will be to complete sheet rock installation

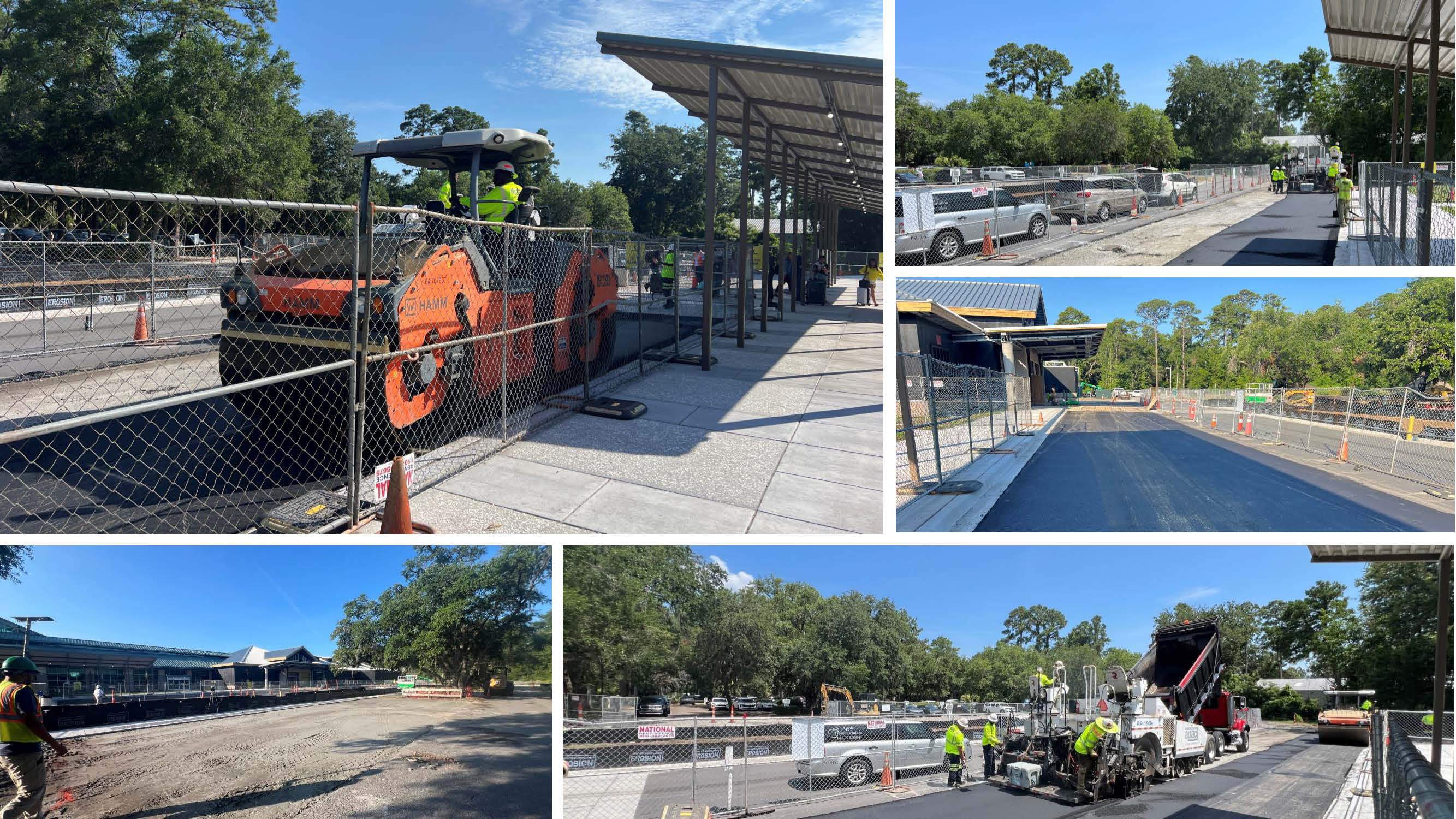

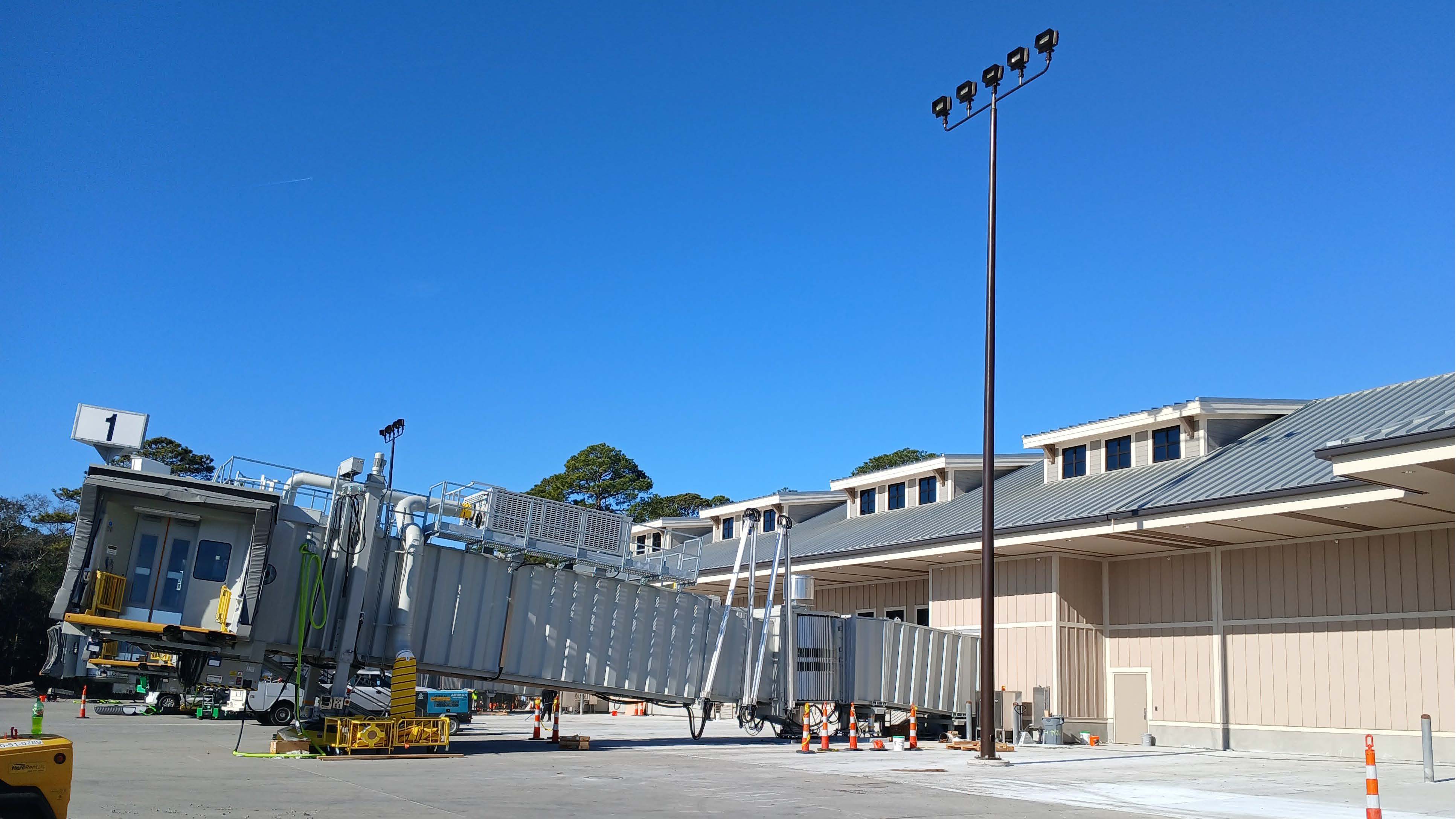

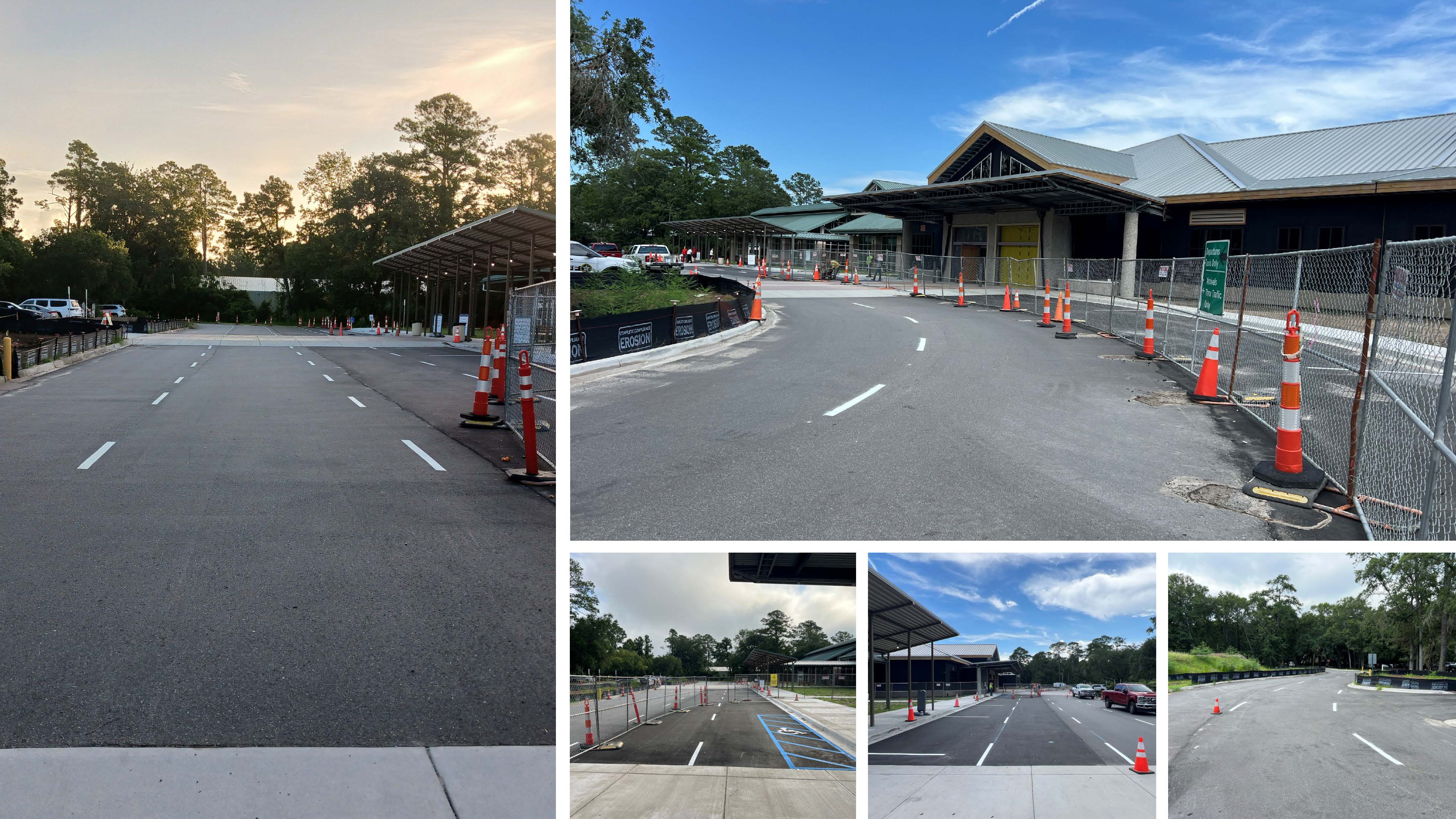

- Pave final arrival lanes for a total of four lanes
NEAR-TERM LOOK AHEAD

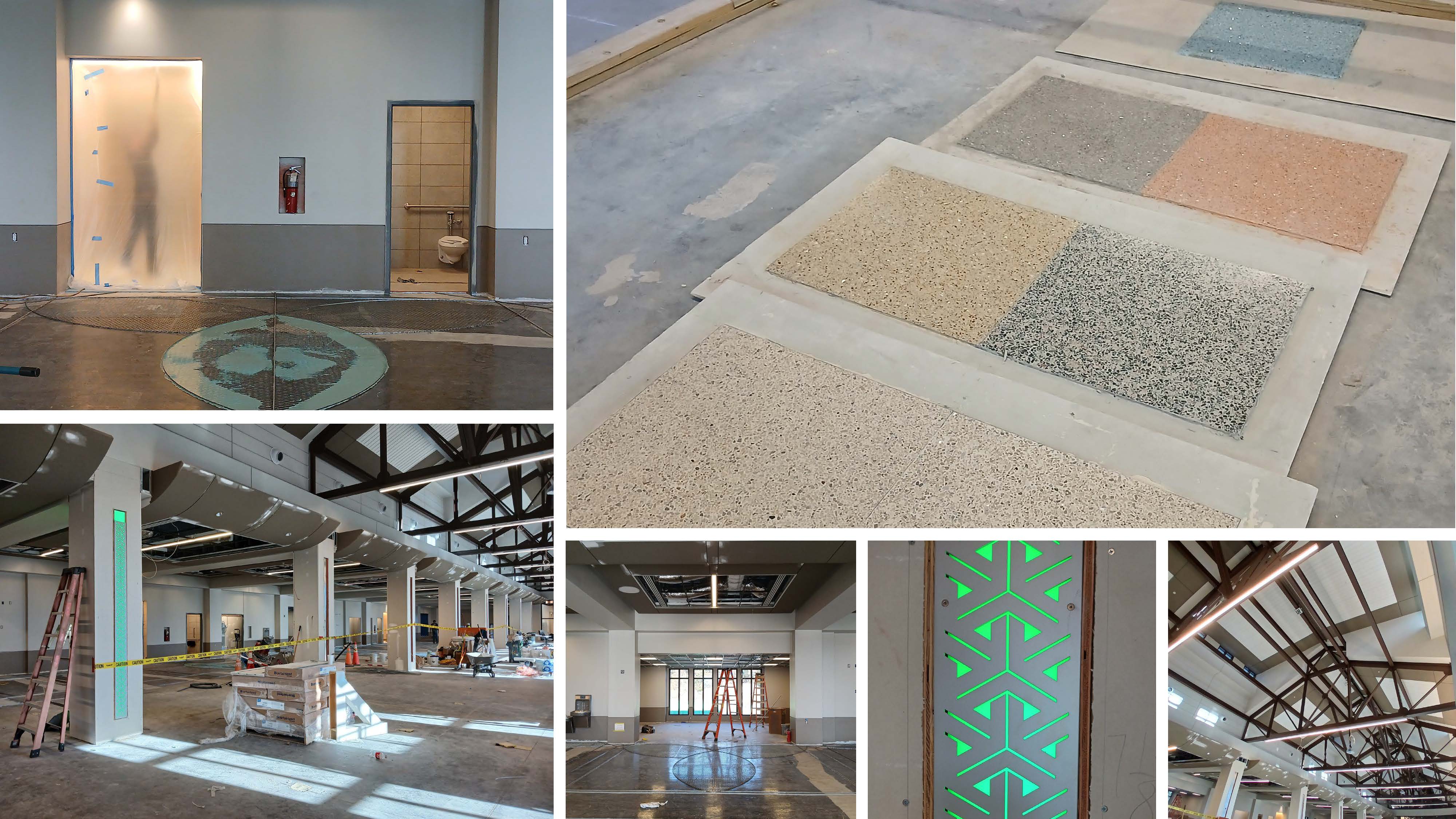

- Terazzo floor test installation

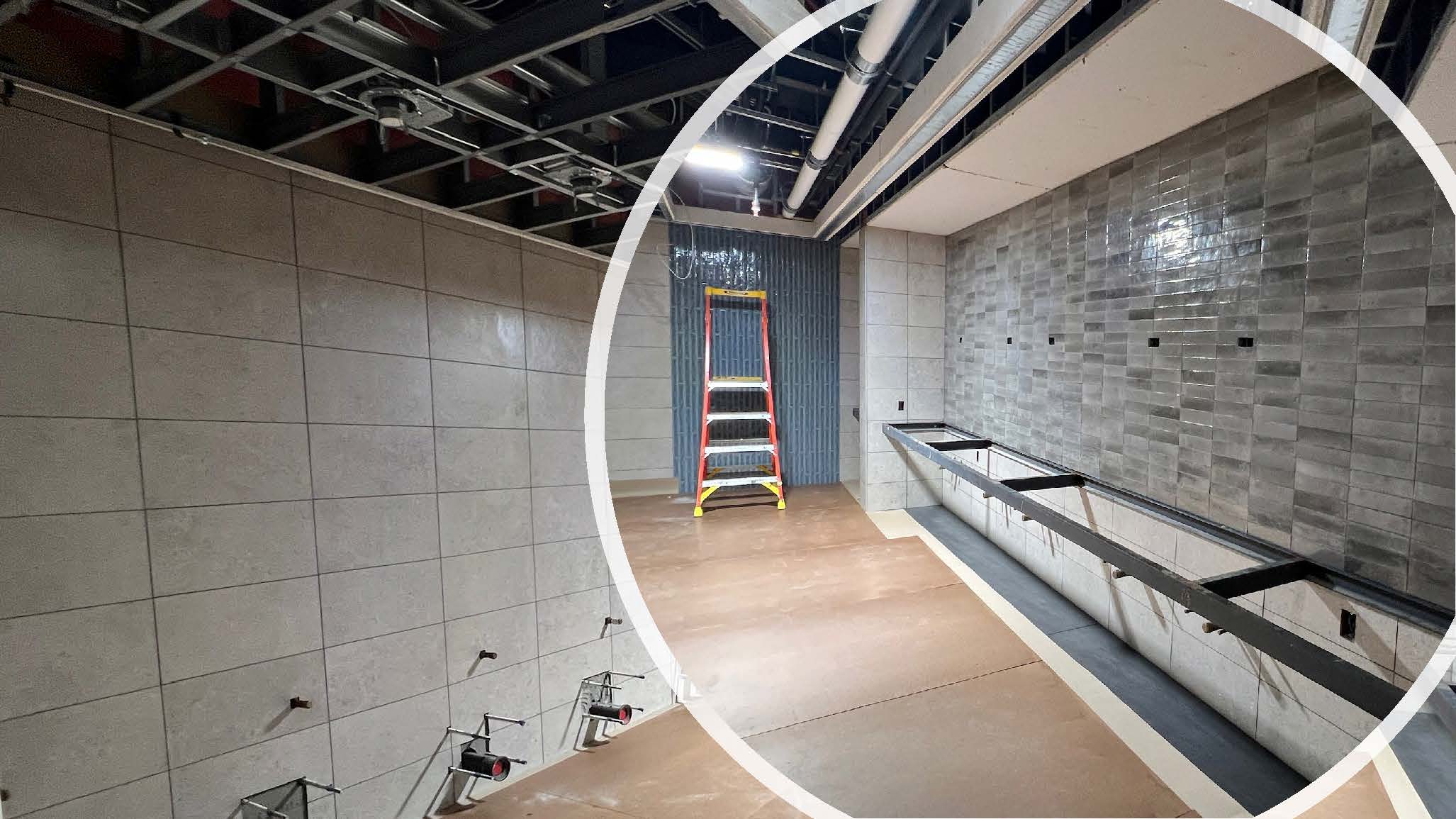

- Wall insulation and interior sheet rock
-
End of May – all lanes will open for summer vehicular traffic



Share Mid-Month Photo Highlights - April 15, 2025 on Facebook
Share Mid-Month Photo Highlights - April 15, 2025 on Linkedin
Email Mid-Month Photo Highlights - April 15, 2025 link
Share Phase I Update and Photo Highlights - March 2025 on Facebook
Share Phase I Update and Photo Highlights - March 2025 on Linkedin
Email Phase I Update and Photo Highlights - March 2025 link

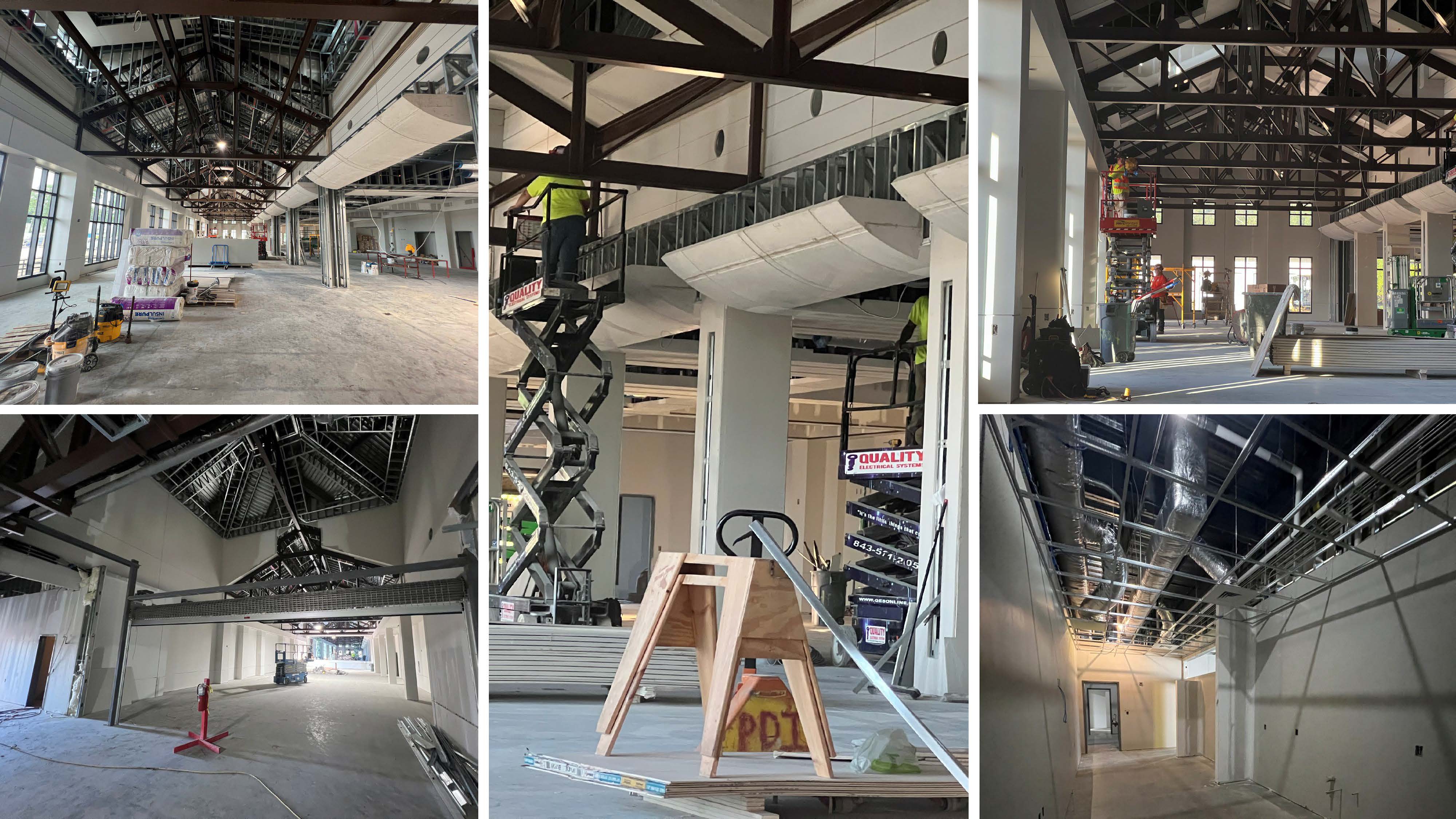

KEY WORK ITEMS ACCOMPLISHED
- Roof installation 80% complete
- Exterior wall Framing 100% complete
- Exterior sheathing and liquid applied vapor barrier 100% complete

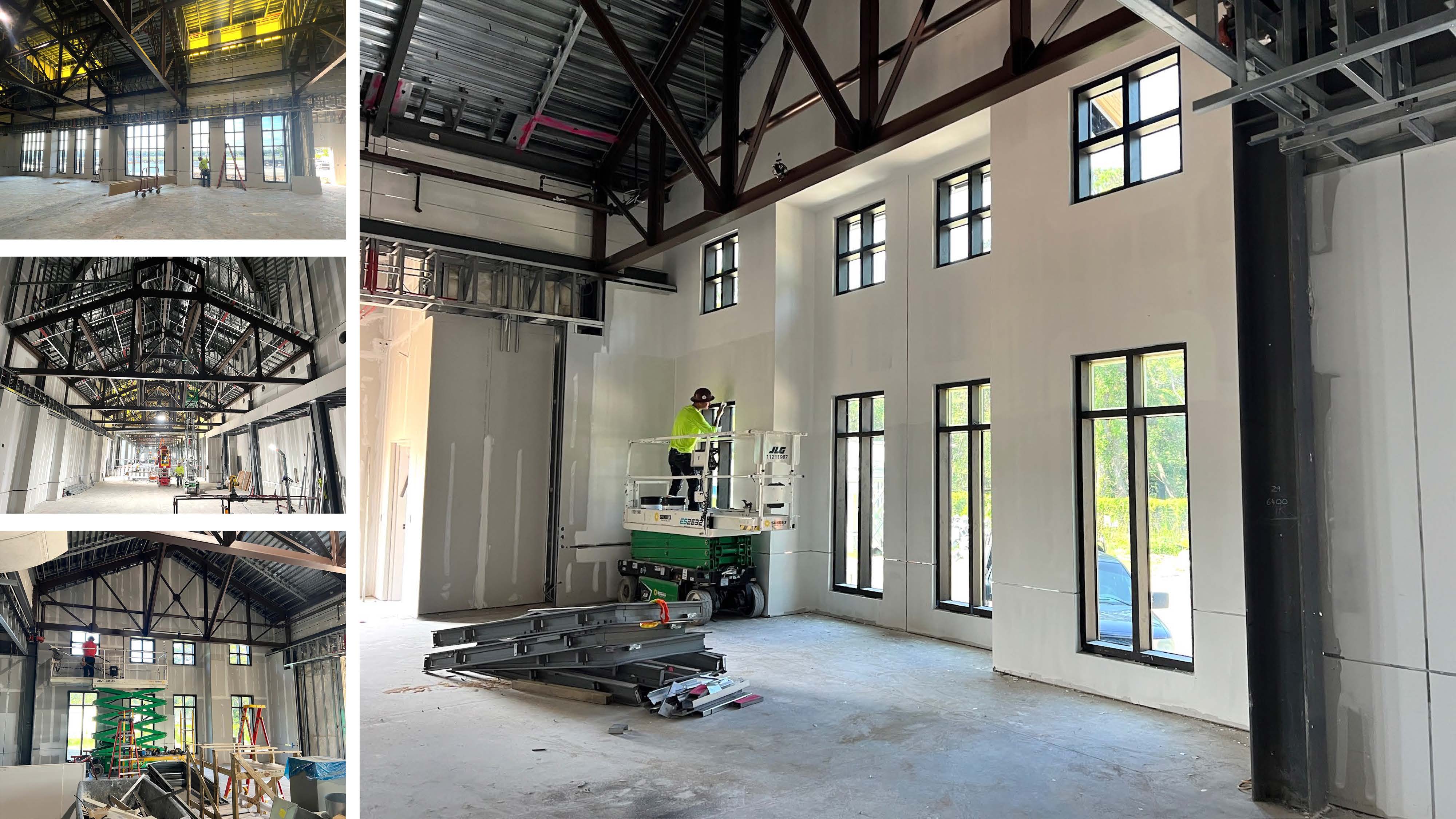

- Interior framing 90% complete, Sheetrock installation started
- Interior water/HVAC/electrical/ Fire suppression 80% complete
- New domestic water and wastewater pipe installation 100% complete

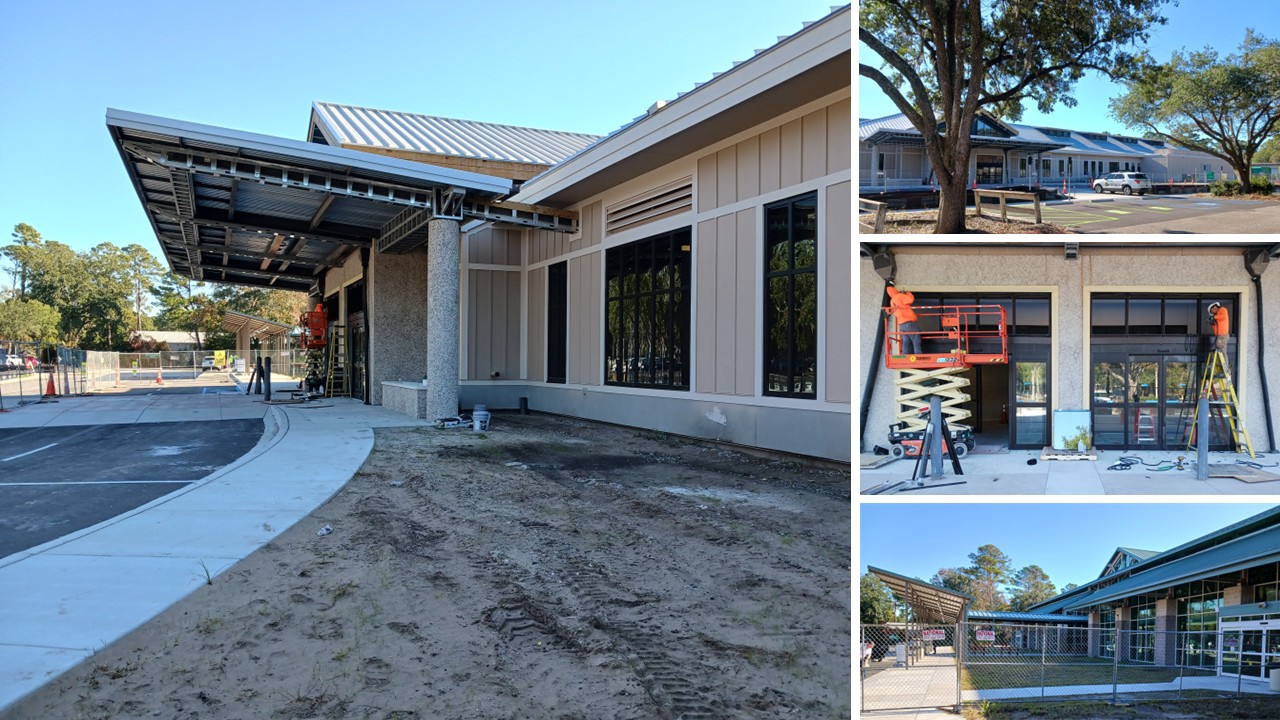

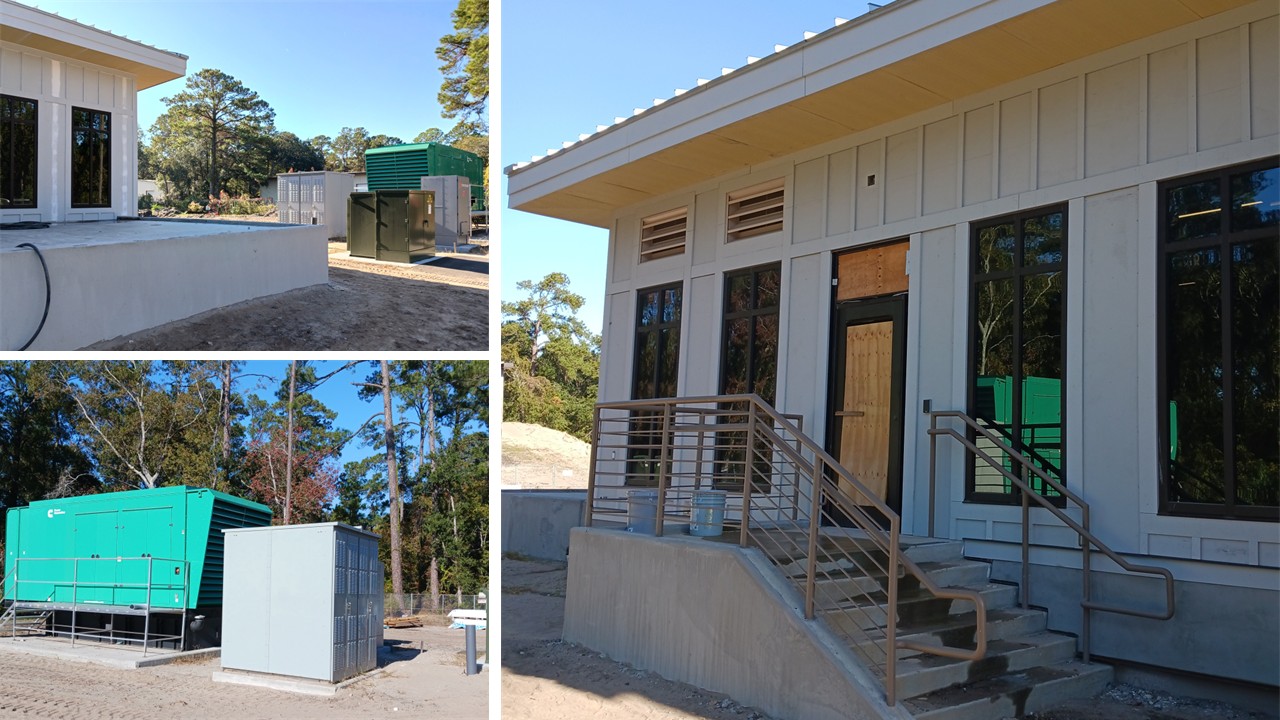

- New Temporary canopy and sidewalks at existing terminal 100% complete
- Window frames and glass installed
- Exterior EFIS is underway and approximately 60% complete
- Interior Painting of exposed steel trusses is 100% complete
IMPORTANT COORDINATING ITEMS
- Continue re-routing passengers through construction zones
- Approve interior graphics, light fixtures and accessories
- Begin parking lot study and prep gate locations
- Next big step will be to complete sheetrock installation
NEAR-TERM LOOK-AHEAD
- Pave two new arrival/departure lanes when canopy is complete
- Continue roof panel installation
- Wall insulation and interior sheetrock
- Continue interior wiring and utility work
- Complete temporary canopy sidewalks



Share Mid-Month Photo Highlights - March 14, 2025 on Facebook
Share Mid-Month Photo Highlights - March 14, 2025 on Linkedin
Email Mid-Month Photo Highlights - March 14, 2025 link
Share Phase I Update - January and February 2025 on Facebook
Share Phase I Update - January and February 2025 on Linkedin
Email Phase I Update - January and February 2025 link
KEY WORK ITEMS ACCOMPLISHED
- Roof insulation 50% complete
- Roof panel installation 70% complete
- Temporary canopy decking 100% complete
- Interior framing 80% complete
- Interior water/HVAC/electrical 50% complete
- Civil work, water, and wastewater pipe installation 40% complete
- Purple exterior sheet rock 100% complete
- Black sealant around exterior 75% complete
IMPORTANT COORDINATING ITEMS
- Continue re-routing passengers through construction zones
- Approve interior graphics, light fixtures and accessories
- Begin parking lot study and prep gate locations
- Next big step will sheet rock installation on the interior
NEAR-TERM LOOK-AHEAD
- Pave 2 new arrival/departure lanes when canopy is complete
- Continue roof panels installation
- Interior sheet rock
- Continue interior wiring and utility work
- Complete temporary canopy
- Begin interior doors and window frame in
